Concrete is tested twice in its life: once while it is fresh — when you can still fix problems — and once after it hardens, when the results decide whether the structure is accepted. This article is the map, not the territory: a complete list of the standard tests in both groups, each with its purpose and a one-line description, linked to the full procedure articles where they exist.
For the science behind what these tests measure, see properties of fresh and hardened concrete.
Fresh Concrete Tests
Fresh tests are done at the mixer or at the point of placement. They answer one question: is this batch fit to place?
| Test | Purpose | One-line method | Full article |
|---|---|---|---|
| Slump test | Workability / consistency | Measure how far a cone of concrete slumps after the mould is lifted | Slump test |
| Flow table test | Workability of flowing concrete | Drop the table 15 times and measure the spread diameter of the concrete pat | Flow table test |
| Vee-Bee test | Workability of stiff, low-slump mixes | Time how long vibration takes to remould a cone into a cylinder | Vee-Bee test |
| Unit weight (density) test | Yield, air-content check and batch consistency | Weigh a known volume of fresh concrete in a calibrated measure (ASTM C138) | Unit weight test |
| Compaction factor test | Workability by degree of compaction | Ratio of partially compacted to fully compacted concrete weight in a standard apparatus | Full procedure article in preparation |
| Bleeding test | Water gain on the surface | Collect and measure bleed water rising from a test specimen over time | Bleeding test |
| Air content test (pressure method) | Freeze-thaw durability, air-entrained mixes | Pressure meter measures air voids in the fresh mix (ASTM C231) | Full procedure article in preparation |
| Concrete temperature | Hot/cold weather concreting control | Thermometer reading of fresh concrete at placement | Temperature limits |
| Setting time (penetration) | Initial and final set | Penetration resistance of mortar sieved from the mix (ASTM C403) | Full procedure article in preparation |
Notes from practice
- Slump is the site workhorse — quick, cheap, and understood by every foreman. But it is a crude measure: two mixes with the same slump can behave very differently in the pump or the formwork.
- Vee-Bee and compaction factor suit the stiff mixes used in pavements and precast work, where the slump cone barely moves.
- Bleeding and temperature are the tests people skip and later regret — one predicts surface defects, the other controls cracking in extreme weather.
- For self-compacting concrete, the standard fresh tests are replaced by flow-based tests: slump-flow, V-funnel, L-box, and J-ring (see the SCC test series on this site).
Hardened Concrete Tests

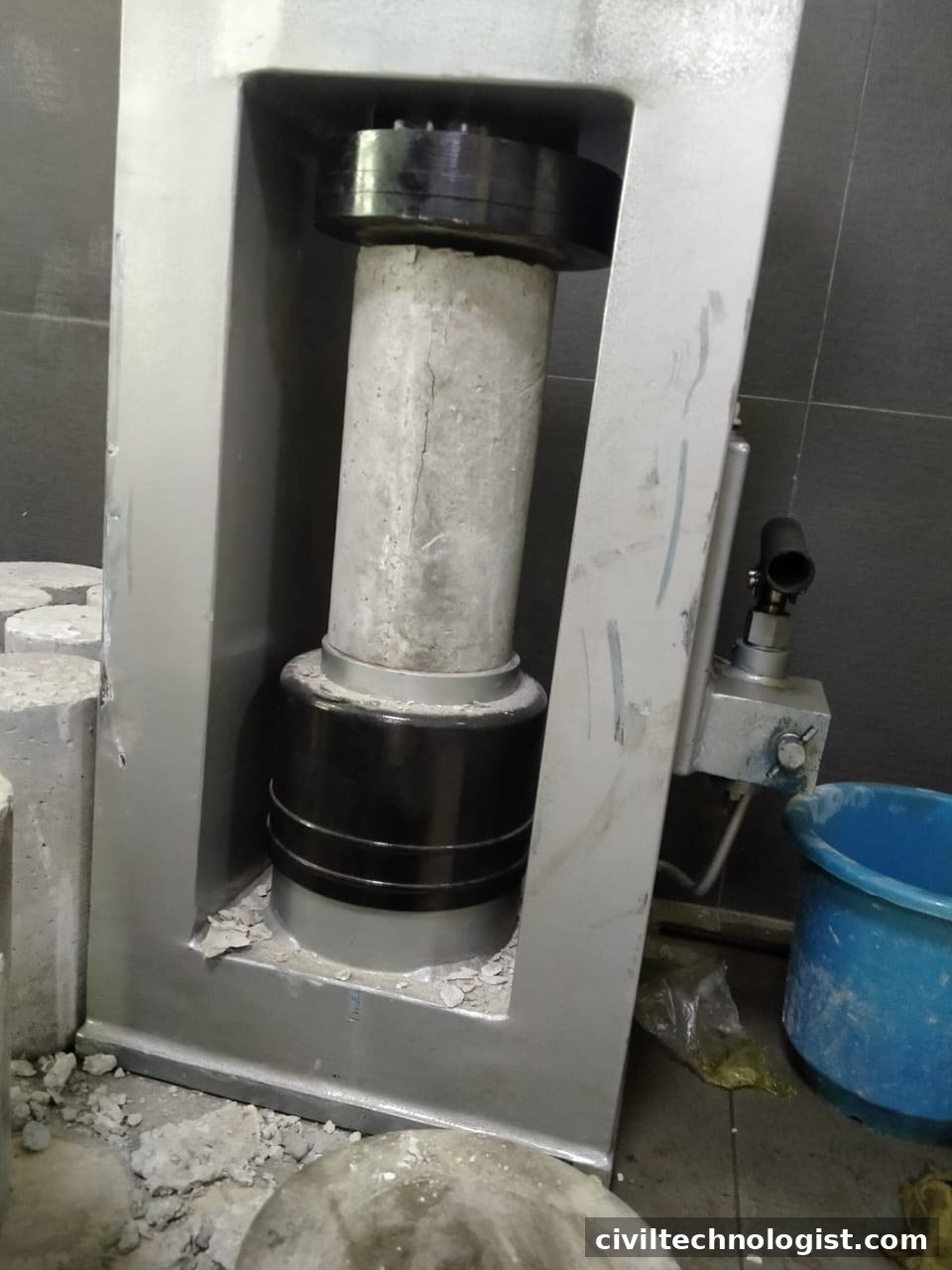

Concrete cylinder after crushing in the compression machine — failure load gives the compressive strength
Hardened tests are done on specimens or on the structure itself. They answer a harder question: did the concrete achieve what the design assumed?
| Test | Purpose | One-line method | Full article |
|---|---|---|---|
| Cube compressive strength | Acceptance of concrete grade | Crush 150 mm cubes at 7/28 days; strength = failure load ÷ area | Compressive strength |
| Cylinder compressive strength | Acceptance (ASTM/ACI practice) | Crush 150 × 300 mm cylinders; ~0.8 × cube strength | Compressive strength |
| Split tensile strength | Indirect tensile strength | Load a cylinder diametrically until it splits along its length | Full procedure article in preparation |
| Flexural strength (modulus of rupture) | Tensile strength for pavements | Load a beam specimen at third points until it breaks | Full procedure article in preparation |
| Rebound hammer (Schmidt) | Estimate in-situ strength, NDT | Spring-driven mass rebounds off the surface; rebound number correlates with strength | Full procedure article in preparation |
| Ultrasonic pulse velocity (UPV) | Uniformity, voids, cracks — NDT | Time an ultrasonic pulse crossing the concrete; velocity reflects quality | Full procedure article in preparation |
| Core test | True in-situ strength | Drill, trim, and crush cores from the structure (ASTM C42) | Full procedure article in preparation |
| Permeability / water penetration | Durability | Measure depth of water penetration under pressure (EN 12390-8) | Full procedure article in preparation |
Notes from practice
- Cubes vs cylinders is a regional choice — 150 mm cubes under BS/IS practice, 150 × 300 mm cylinders under ASTM/ACI. The 0.8 conversion factor between them is covered in the compressive strength article.
- NDT methods (rebound hammer, UPV) estimate strength indirectly. They are excellent for comparing areas of a structure and locating suspect zones, but they do not replace crushed specimens for acceptance.
- Cores are the last word when strength results are disputed — drilled from the actual structure, corrected for aspect ratio and reinforcement, and judged against their own acceptance criteria.
Which Tests for Which Job?
- Every pour, every day: slump, temperature, and cube/cylinder casting. Non-negotiable.
- Pavements and precast: add vee-bee or compaction factor for the stiff mixes involved.
- Mass concrete / extreme weather: temperature monitoring and setting time become critical.
- Disputed or failed results: rebound hammer and UPV for investigation, cores for the final verdict.
- Durability specifications: permeability and air content where the design demands them.
Acceptance Tests vs Investigation Tests — Know the Difference
Not every test carries the same weight, and confusing the two kinds causes most arguments on site. Acceptance tests decide pass or fail: the cube and cylinder compressive strength tests are the acceptance tests for concrete grade. If the 28-day cubes fail, the concrete is formally non-conforming, whatever any other test says. Investigation tests explain why: rebound hammer, ultrasonic pulse velocity, and cores investigate a structure — they locate weak zones, compare areas, and confirm what really happened. A low rebound number never fails a structure by itself, and a good rebound number never saves failed cubes. The chain after a failed cube set is fixed: first check the casting and curing records, then survey the area with rebound hammer and UPV, then drill cores for the final verdict, and only then — if the cores also fail — does the structural engineer decide on strengthening or load testing. Skipping straight to cores wastes money; skipping NDT wastes the chance to find the real problem.
Testing Schedule: When Each Test Happens on a Real Project
Before the pour: trial mixes are tested in the laboratory, and the trial batch is checked with a slump test before full production is approved. This is where the mix is fixed — after the pour starts, it is too late.
During the pour: slump and temperature are checked on every truck or load as it arrives, and cubes or cylinders are cast at the frequency the specification demands — commonly one set per day’s pour or per 50 m³, whichever comes first. The cubes are labelled with the pour location, date, and truck number, because an unlabelled cube is useless evidence.
At 7 days: the first cubes are crushed. The 7-day result (usually 65–70% of the 28-day strength) is an early warning, and it is also the number the engineer uses to decide whether formwork can be struck.
At 28 days: the acceptance cubes are crushed. This is the result the grade stands or falls on.
Later, only if needed: rebound hammer and UPV for investigation, cores when results are disputed, and durability tests (permeability, air content) wherever the specification demanded them. A project that reaches the core-drilling stage has already had a failure somewhere upstream — good testing schedules are designed so it never gets there.
Five Mistakes That Ruin Concrete Test Results
1. Sampling from the wrong part of the load. The first and last concrete out of a mixer truck is not representative — it is wetter, or stiffer, than the middle. Samples must come from the middle third of the load, after a short discharge. A cube cast from the first wheelbarrow tests the truck, not the pour.
2. Curing cubes on site in the sun. Acceptance cubes must be standard-cured — in a water tank at about 27°C — not left on a wall in the sun and wind. Site-cured cubes read low, and then the argument starts about whether the concrete or the curing failed. Keep one set site-cured if the engineer wants it, but never let it replace the standard-cured set.
3. Testing at the wrong age. A cube crushed at 26 days is not a 28-day result, and a cube crushed at 30 days is not one either. Strength grows with age, so the age must match the specification exactly, or the result cannot be compared with the acceptance limit.
4. Rebound hammer on an unprepared surface. Carbonated surfaces, rough finishes, and wet concrete all distort the rebound number. The surface must be smooth, dry, and ground flat where the hammer strikes — and the hammer itself must be calibrated and checked against the test anvil.
5. UPV without calibration or coupling. Ultrasonic pulse velocity needs a calibrated instrument, good contact between transducer and concrete (coupling gel, no air gap), and a known path length. Without those, the numbers look precise and mean nothing. Record the path length and the calibration check with every reading.
Frequently Asked Questions

Filling concrete cube moulds in layers — the starting point of hardened concrete strength testing
What is the difference between fresh and hardened concrete tests?
Fresh tests check workability and placability before the concrete sets; hardened tests verify strength and durability after it gains strength.
Which concrete test is most important?
The compressive strength test — it is the acceptance test that decides whether a concrete grade (like M25 or C30) was actually achieved.
Can NDT replace cube crushing?
No. Rebound hammer and UPV are investigation tools. Acceptance is based on standard crushed specimens — or on cores when results are challenged.
How many cubes should be cast per pour?
Practice varies by code and project size; a common site rule is at least one set (3 cubes) per day’s pour or per 50 m³, with sets tested at 7 and 28 days. Always follow the project specification.
Why test both slump and temperature?
They catch different failures: slump catches wrong water content and workability problems; temperature catches hot-weather flash set and cold-weather freezing risk.
What happens if the 28-day cubes fail?
Do not panic and do not hide it. Check the 7-day trend and the casting and curing records first, then investigate with rebound hammer and UPV, then cores if needed. The project specification — not the laboratory — decides acceptance, and the structural engineer decides the remedy.
Do we test every truck?
Slump and temperature on every truck is common practice and cheap insurance. Cubes are cast per batch or per day as the specification requires — usually one set per day’s pour or per 50 m³.
How soon can formwork be removed?
It depends on early strength, judged from the 7-day cubes or a maturity reading — never by guessing. The structural engineer gives the instruction; removing formwork early to save time has collapsed more than one slab.
Final Thoughts
Testing is not paperwork — it is the feedback loop that keeps concrete honest. Run the fresh tests so bad batches never reach the formwork, crush the specimens so the design assumptions get verified, and keep the NDT tools ready for the day the numbers disagree. This list is your map; the linked articles are the detailed routes.
